Abstract
The Full Country Evaluations were Gavi-funded real-time evaluations of immunisation programmes in Bangladesh, Mozambique, Uganda and Zambia, from 2013 to 2016. The evaluations focused on providing evidence for improvement of immunisation delivery in these countries and spanned all phases of Gavi support. The process evaluation approach of the evaluations utilised mixed methods to track progress against defined theories-of-change and related milestones during the various stages of implementation of the Gavi support streams. This article highlights complexities of this type of real-time evaluation and shares lessons learnt on conducting such evaluation from the Zambian experience. Real-time process evaluation is a complex evaluation methodology that requires sensitivity to the context of the evaluation, catering for various information needs of stakeholders, and establishment of mutually beneficial relationships between programme implementers and evaluators. When used appropriately, it can be an effective means of informing programme decisions and aiding programme improvement for both donors and local implementers.
Introduction – Full country evaluation (FCE) overview and objectives
The Gavi Full Country Evaluation (FCE) was a real-time evaluation of immunisations programmes in Bangladesh, Mozambique, Uganda and Zambia, covering the period 2013–2016. The evaluation aimed to understand and quantify drivers and barriers of immunisation programme improvement, defined by the FCE as factors that promote or hamper programme success, respectively. The evaluation was funded by Gavi and spearheaded by the Institute for Health Metrics and Evaluation (IHME) of the University of Washington (UW) and PATH at the global level, in collaboration with country FCE teams. These were International Centre for Diarrhoeal Disease Research, Bangladesh (icddr,b) in Bangladesh; University of Eduardo Mondlane in Mozambique, Infectious Diseases Research Collaboration (ICDR) in Uganda and the University of Zambia (UNZA) in Zambia. The FCE was focused on providing evidence for improvement of immunisation delivery in FCE countries and spanned all phases of Gavi support, from application decision, application process, approval, preparation for implementation, implementation and post implementation evaluation and/or review.
In Zambia, the Gavi alliance provided support for the introduction of pneumococcal conjugate vaccine (PCV), rota virus vaccine (Rota), measles rubella vaccine (MR), inactivated polio vaccine (IPV) and human papilloma virus (HPV) vaccine. In addition, the alliance also provided support towards health systems strengthening (HSS). These are highlighted in Table 1. The Zambia FCE team tracked and provided real-time evaluation for these streams of support, providing ad hoc policy recommendations using policy briefs and annual evaluation reports that were disseminated to all country Expanded Programme on Immunisation (EPI) stakeholders. In tracking and evaluating these different streams, a theory-of-change (TOC) was developed for each stream as a conceptual model defining conditions necessary for change to occur in a programme and for desired goals to be achieved, with critical milestones outlined (Anderson, 2005). In all the streams of support the evaluation assessed the following: (1) the relevance of the support, (2) effectiveness and impact by considering the extent to which the intervention was meeting the set goals, (3) efficiency by considering other alternatives that may have been available and (4) sustainability of the support Gavi was providing.
Streams of Gavi support for evaluation in Zambia under the FCE.
Source. Gavi (2015) Full Country Evaluation Report – Zambia; https://www.gavi.org/programmes-impact/our-impact/disbursements-and-commitments, accessed 21 November 2016.
Values shown represent Gavi commitments, those of which Gavi intends to fund over the course of the programme, subject to performance and availability of funds. FCE: Full Country Evaluation.
Earlier phase of support was for tetra DPT-hep B.
This article is an attempt to share lessons learnt from such complex evaluations in order to inform other evaluations in the future. This article documents some salient features of such real-time evaluation, the strengths and weakness, but more importantly, what the team learnt in the process. This article does not discuss the findings of the evaluation as these are adequately discussed in the annual reports on the Gavi website. 1
Rationale
A lot of programmes and/or interventions have been evaluated in different jurisdictions. The methods of real-time evaluations have also been employed before. However, the environment and contexts will always differ from one evaluation to another. Therefore, this article attempts to present lessons from Zambia, with its unique context, as the authors were all part of the Zambian FCE team.
Objective of this article
This article highlights complexities of real-time evaluation and shares lessons learnt in conducting such evaluation. The specific objectives of this article are to:
provide perspectives on the evaluation methodology and its associated advantages and disadvantages based on the practical experience of the Zambia FCE team.
share lessons learnt around adaptations to the approach as a result of this learning during the conduct of the evaluation itself.
This article is divided into four sections. The first details the overall evaluation rationale and methodology and leads into the second that delves into the relevance and usefulness of the evaluation to programme implementers. The third section explores how to handle the challenge of balancing evaluator roles and avoiding bias. Finally, the ‘Lessons learnt’ section gives a summary of key learning points from each of the preceding sections.
Evaluation approach
This section defines key terms and details the rationale and methodology for the evaluation.
The real-time evaluation approach of the FCE utilised mixed methods to track progress against theory-of-change and related milestones through process evaluation during the various stages of implementation of the Gavi support streams. Real-time evaluation involves carrying out an evaluation during programme implementation with quick feedback to implementers (Sandison, 2003). Process evaluation can be one way of conducting real-time evaluation and can provide a detailed means of utilising mixed-method approaches in determining what factors of a programme, often according to the theory-of-change, contribute to successful implementation and outcomes or otherwise (Coryn et al., 2011; Linnan and Steckler, 2002; McIntyre et al., 2018; Saunders et al., 2005). It can also aid in confirming that an intervention was actually implemented before allocating or wasting further resources evaluating its effectiveness (Scheirer et al, 1995 as cited by Saunders et al., 2005). More recently, the process evaluation approach has been recommended for public health research as an essential part of designing and testing complex interventions (Moore et al., 2015).
The Gavi funded programmes of the EPI in Zambia were suitable for such a process evaluation approach as they were theory-driven and thus links in the chain of events from planning, implementation, outcomes and impacts could be assessed during an entire programme life-span rather than at the end, allowing adjustments to be made by implementers as well as the funder in formative stages (Marjanovic et al., 2017). Such theory-driven process evaluation is important in understanding a programme’s underlying causal mechanisms that lead to observed results (Coryn et al., 2011).
Process evaluation can be prospective or retrospective in being either formative or summative (Saunders et al., 2005) and in the case of the FCE a prospective approach was taken in conducting this real-time evaluation of the EPI programme. The FCE process evaluation consisted of document review, key informant interviews (KIIs), fact-checking interviews (FCIs), focus-group discussions (FGDs), meeting observations, field visits, surveys aimed at implementers and analysis of programmatic data. For outcome and impact evaluation, various large surveys were conducted as well as utilising programmatic data and data from the country’s health management information system (HMIS). Quantitative studies carried out included a household survey in 2014, a health facility survey in 2014, two resource tracking surveys in 2014 and 2016 and a dry blood spot survey in 2014.
Evaluation relevance and usefulness to programme implementers
This section explores the intricacies of communication and stakeholder engagement during real-time evaluation.
Stakeholder buy-in at inception stage
Stakeholder buy-in is very important in real-time evaluation. It enables researchers to have unlimited access to the programme and associated activities and meetings. The evaluation made use of methodologies such as meeting observations and KIIs which are only practical with good buy-in from stakeholders. Therefore, selling the relevance of the evaluation helps prevent resentment which might induce unintended behavioural change. Furthermore, real-time evaluations must regularly provide feedback to the programme and there must be an uptake of recommendations by the implementor.
In order to secure such buy-in, formal correspondence was done and meetings were held at inception with the ministry and other EPI stakeholders, notably; the Child Health Unit (CHU) of the ministry of health (MOH), United Nations Children’s Fund (UNICEF), World Health Organization (WHO), Centre for Infectious Disease Research in Zambia (CIDRZ), Churches Health Association of Zambia (CHAZ), Central Statistical Office (CSO) and OXFAM. The engagement of stakeholders and buy-in was high from inception as a result of this early consultation and is a recommended approach by others who have carried out this form of evaluation (Marjanovic et al., 2017; Sandison, 2003; Saunders et al., 2005.) in order to ensure a common understanding of the evaluation approach and determine its feasibility from the beginning.
Further engagement during planning for buy-in at later stages
In the final year of the FCE, the EPI represented by CHU, participated in the preparation of the annual work plan and priority setting for the 2016 evaluation as a way of getting further buy-in and their input into the evaluation. This was important in the process evaluation to ensure that both the data collection and management burden for the evaluation team and time for providing data on the programme’s side were balanced. These cost implications and the fact that such evaluations are expensive is also reported by Marjanovic et al. (2017) who emphasise a balance between what is desirable and what is feasible in terms of information needs.
Managing expectations of stakeholders regarding evaluator roles
As the evaluation progressed there was misunderstanding and frustration by some stakeholders regarding what the FCE was mandated to do. Observation and interviews revealed that the relationship was seen by some stakeholders as being one of grading the EPI on their performance at the end of every year, rather than being useful to their ongoing planning and decision-making. The FCE was even perceived by some to be Gavi ‘spies’. Some stakeholders indicated that they would have liked the evaluation team to contribute to discussions and decisions at various technical working group (TWG) and the inter-agency coordinating committee (ICC) meetings. This misunderstanding affected notification of the FCE about the meetings that were being held and meant that the team had to work extra hard to ensure that they were aware of all meetings through regular follow up with CHU, a notable challenge to the evaluation during the inception phase.
In order to address these concerns, through several meetings with stakeholders, the FCE explained that as evaluators they were unable to make decisions affecting the same programme they were evaluating as this brought about an obvious conflict of interest (Sandison, 2003). A more appropriate approach that was adopted in response was to be a provider of additional data and information as obtained through the evaluation that would be of value to the programme at various meetings, without participating in decision-making. Sharing of lessons from other FCE countries was an added approach that proved to be of value to Zambia’s EPI.
Making information available to stakeholders in a timely manner for decision-making
In the early part of the FCE, evaluation results were shared through annual reports comprising a country report specific to Zambia and a cross-country report synthesising findings from all the FCE countries. A draft report was initially sent to EPI stakeholders through CHU at the end of the year for their comments before it could be finalised. PowerPoint presentations at TWG meetings were an additional means of getting feedback on the draft report. Stakeholders would then sit to provide written feedback or comments to the draft report. Revisions were made based on this feedback, without compromising the findings. The climax of the report dissemination was a 1-day dissemination workshop involving broader EPI stakeholders that was held in the first-quarter of the following year. This workshop was often attended by heads of institutions and hosted by the permanent secretary at MOH or his or her designate. The purpose of this workshop was to share findings with policy makers and allow all EPI stakeholders to have additional input into the final report.
In addition, rather than sharing findings only through annual reports, the FCE started to share its findings at the various TWG meetings as and when needed to aid ongoing discussions. Furthermore, as the evaluation progressed and the need for more timely sharing of findings emerged, written quarterly briefs were prepared, giving key findings or summaries of lessons from ongoing work and from other countries. A summarised version of the annual report was also prepared in later years of the evaluation that busy EPI stakeholders could quickly engage with. Thus, information sharing became an important aspect of FCE work and the information was more tailored to the needs of the stakeholders. Such information-sharing is also detailed by Marjanovic et al. (2017) in their evaluation of the African Institutions Initiative (AII) and reflects the need to be relevant and useful to the programme being evaluated (Marjanovic et al, 2017; Sandison, 2003).
However, balance had to be reached between sharing emerging findings that were needed for improving implementation versus sharing findings relating to effectiveness (outcomes) of the programme in order to not compromise the external validity of the evaluation (Moore et al., 2015). An additional low effort but highly beneficial way of being useful to the EPI was for the FCE to volunteer to take meeting notes and passing these on to relevant EPI staff for minute preparation and other records. This was also an efficient way of gathering notes to be utilised by the evaluation itself and to ensure active participation in meetings rather than being seen to be aloof observers.
Ensuring added value of the evaluation to programme information needs
In some instances, stakeholders felt that they were already aware of EPI programme challenges that the FCE was highlighting. In such cases, the added value of the FCE was to tease out and understand more deeply the relationships between the various known factors in order to determine what factors were most important to deal with in addressing these challenges and thus make more appropriate and realistic recommendations (Sandison, 2003). This was achieved through root cause analysis (RCA), which is a form of bottleneck analysis that seeks to investigate and categorise the root causes of events (Rooney and Vanden Heauvel, 2004). A ‘root cause’ is a key factor in a causal chain of events that, if removed from the sequence, would prevent the final undesirable or desirable event from occurring or recurring (Rooney and Vanden Heauvel, 2004). RCA was also used to understand which components of the interventions contributed to successes when interventions led to significant results, an important use of process evaluation (Rooney and Vanden Heauvel, 2004). This helped to identify the most important bottlenecks and success factors in addressing known challenges and was appreciated by stakeholders as an added benefit of the FCE. Figure 1 is an example of RCA done for understanding Zambia’s initial HSS application to Gavi in 2015, which required a resubmission at the time.

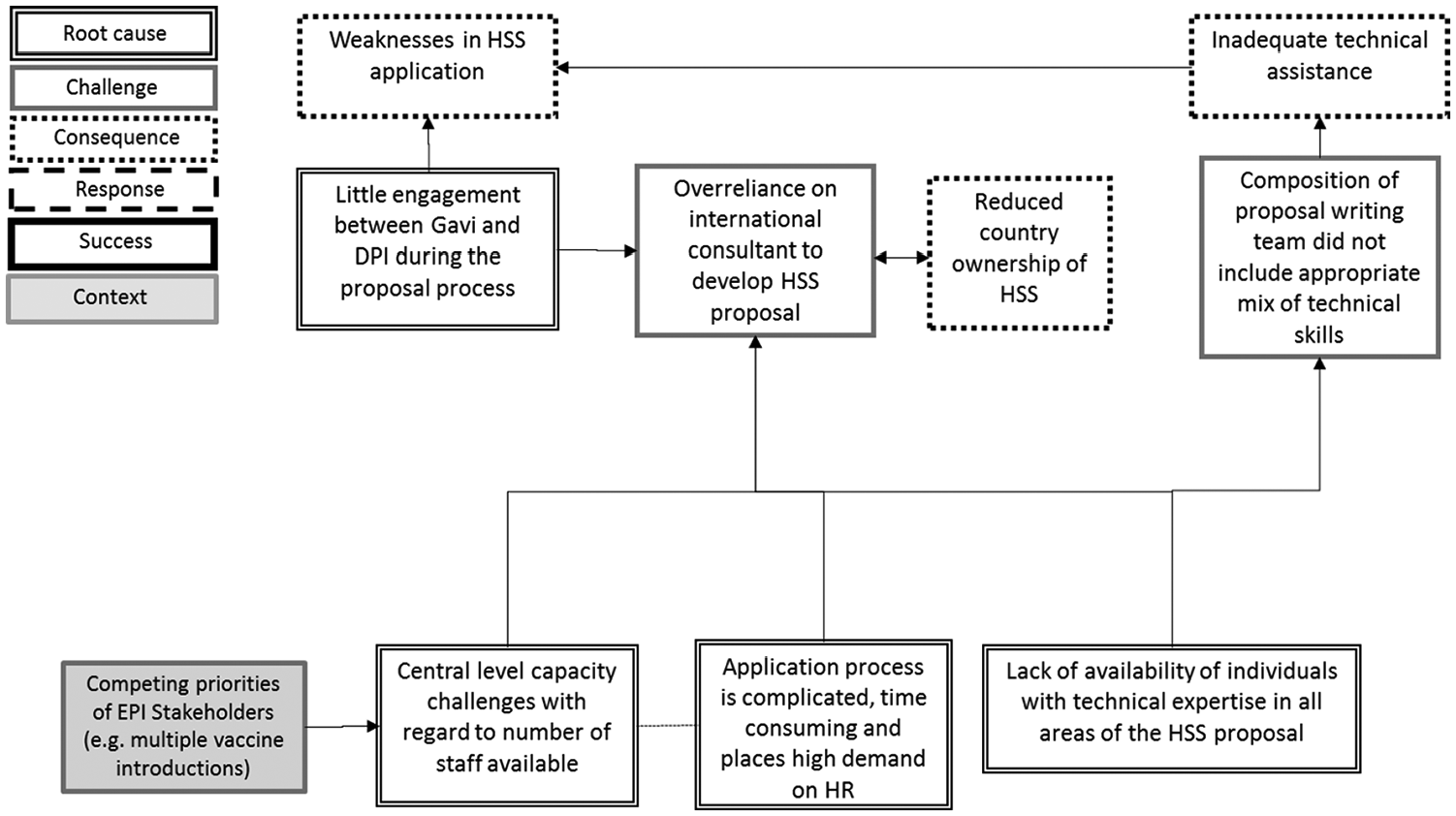

Root cause analysis of Zambia’s initial HSS application weaknesses.
Evaluation integration in ongoing programme activities
The FCE normally conducted one round of KIIs and FGDs annually to gather additional data that it may not have been able to get through ongoing observations, FCIs and document review. This was done in order to avoid requesting multiple interviews of stakeholders annually. The process of obtaining permission to conduct the interviews was another consideration for having one round of KIIs annually as it required first having ethical approval from the UNZA research ethics board, administrative approval from the permanent secretary of the ministry and finally approval from relevant organisational heads after the ministerial approval was granted. Then scheduling of interviews was done. Clearly this was a heavy administrative burden that could not be done often.
It was, therefore, important in an evaluation of this nature to ensure that evaluation activities were integrated into programme activities and did not place an unnecessary additional time-burden on an already constrained system such as EPI that had limited human resources both in government and among stakeholder. Methods of gathering information and feedback effectively but with as little disruption to and time required by the programme are needed for such evaluations (Sandison, 2003). These included embedding evaluation activities into ongoing meetings and utilising every opportunity available to gather data and share information. Specific activities that required dedicated stakeholder time, such as KIIs and surveys, were minimised but used effectively.
Evaluation acceptance
As a result of the measures detailed in this section, the FCE was perceived to be part of the team rather than outsiders and was invited to all EPI meetings as part of the official mailing list, as well as included in the EPI WhatsApp group, and thus became more involved in attending programme activities, lessening the need for regular follow up to get meeting notices and gather data. Following these measures, the EPI would often call on the FCE to help understand some phenomenon or data that needed further investigation. Thus, these measures helped the evaluation to be accepted as a useful part of the programme rather than being there purely for the purpose of gathering information for its own reporting needs. This is evidenced in Zambia by the various FCE findings that have been cited in many EPI grant applications, reports and other documents.
Evaluator roles and balance
This section explores the challenges of avoiding bias, maintaining goodwill of programme implementers and avoiding conflicts of interest during real-time evaluation.
Getting consensus and balancing reporting of negative and positive findings
Real-time evaluation presents challenges that are different from evaluating programmes retrospectively. One of these challenges is the need for the evaluator to continually engage with the programme and share evaluation findings regularly. It was the experience of the FCE team that stakeholders normally accepted positive findings better than negative findings. Negative findings presented a challenge given that the evaluation team still had to interact and engage with stakeholders who may have been shown in a negative manner in reports.
Thus, the FCE had to find means of presenting findings in such a manner that the phrasing of the findings, even if they were negative, was acceptable to stakeholders without changing the overall meaning of the findings. It was also important for the evaluation reports to have balanced approach of reporting both positive and negative findings as opposed to the usual evaluation temptation to be stronger on negative findings. The process of getting feedback on the annual report as outlined previously was useful in this aspect as stakeholders felt they were consulted and made contributions before the report was finalised. Thus, the reports and findings were perceived as a reflection of consensus among the various stakeholders in the EPI programme, rather than the potentially biased opinion of any single group of people or the FCE, even when negative findings were reported. Such consensus gathering is a key aspect of many Gavi processes (Gandhi, 2015), including this evaluation.
Weighing the need to report sensitive information
In the course of the real-time evaluation, the evaluators also came across information that was perceived to have been of a sensitive nature, especially with regard to political factors. In such instances, the FCE had to weigh the benefit of this information to both the country stakeholders and to Gavi as the two important users of the reports. The added value of such information to understanding the findings was weighed and such information was included where absolutely necessary, but otherwise excluded. Furthermore, with real-time evaluation the picture evolves quickly and challenges may be transient and not relevant to overall programme achievements in the long run (Sandison, 2003). The strength of the evidence for such sensitive information was thus also weighed and only included if this was very strong. This was important for ensuring the goodwill of the ministry and EPI to the FCE, and is an inevitable consideration in such evaluations. It may be easy for programmes to frustrate evaluation efforts in instances where they are perceived to be antagonistic to the programme, the country’s image and overall objectives and success.
Finding means of participating in the programme without compromising evaluator roles
There were other means of being relevant to a programme being evaluated that did not compromise the evaluator’s role and maintained evaluator independence (Moore et al., 2015), such as note-taking and sharing, providing information as needed and when called upon, and helping to trouble-shoot arising data challenges in the programme in order to understand them better and provide insight to the programme. The emphasis here was on the evaluator building relationships and rapport with people in the programme they were evaluating so that they were more receptive to sharing information and saw the evaluator as a useful partner rather than as an outsider seeking to grade their performance (Marjanovic et al., 2017). That good working relationships are essential to quality process evaluation is recognised in the Medical Research Council’s guidance on conducting process evaluation (Moore et al., 2015).
Avoiding bias
In such circumstances where evaluators are actively engaged at all stages of programme implementation, bias or systematic deviation of results from what they should be (Camfield et al., 2014), needs to be avoided. In particular, friendship bias, a form of contextual bias in which the evaluator may be wary of upsetting programme staff with a very critical report due to having developed a good relationship with them, must be avoided (Camfield et al., 2014; White and Phillips, 2012). This may be further complicated by more cognitive bias of giving more weight to findings or opinions of people the evaluators are most in contact with and thus identify more with (White and Phillips, 2012). Respondent bias, including political correctness and courtesy bias, where key informants responded according to what they thought was the desired answer during interviews (White and Phillips, 2012), sometimes arose as they felt that the FCE was representing Gavi, who were the funders of both the evaluation and a large part of EPI itself.
The FCE team avoided bias by relying on the appropriate TOC to guide investigation and findings, interviewing as wide a range of stakeholders as possible, and reporting both negative and positive findings as appropriate. An example of such a TOC utilised in the Measles/Rubella (MR) campaign is provided in the supplemental material. Accountability to a wider team of evaluators outside Zambia (IHME, PATH and other FCE counties), as well as Gavi as evaluation funders, as described in the section that follows, also helped to address this. In addition, the FCE developed a robustness ranking of evidence which considered triangulation of data (or the number of data sources), the continuum of fact to perception (the more the findings rest on objective factual information as opposed to perceptions, the more robust was the finding) and the quality of data from each source. This was used to grade each finding as outlined in Table 2. In addition, using a mixed-method approach integrating qualitative and quantitative methods allowed more detail about the programme and aided triangulation that neither method could achieve alone (Linnan and Steckler, 2002).
Gavi FCE robustness ranking for findings.
Source. Gavi (2015) Full Country Evaluation Report – Zambia.
FCE: Full Country Evaluation.
A case in point illustrating this avoidance of bias was the 2015 Gavi FCE annual report (Gavi, 2016) for Zambia which was initially perceived as having been largely negative by many EPI stakeholders. But through the consultative process of validating the report as outlined in the foregoing section, the FCE was able to get consensus from stakeholders on the findings and acknowledgement that 2015 had been a relatively tough year for the programme.
Meeting needs of evaluation funders and collaborating with evaluation partners
This section looks at the wider role of real-time evaluation in fulfilling funder and partner needs.
Being relevant to funder needs
As real-time evaluations of this nature are usually funded by donors, in this case Gavi, it was important to ensure that the evaluation also addressed donor needs and not just EPI needs. In order to achieve this, the FCE held monthly update conference calls with the Gavi monitoring and evaluation (M&E) team in order to update them and get their continued input into the work being done. This helped to ensure that evaluation work was on track to meeting funder needs. In addition, the evaluation findings had to be comparable across the four countries without compromising the unique features, context and needs of each country. This was achieved through several mechanisms, including the hosting of mid-year multi-partner meetings with the aim of sharing emerging findings and informing subsequent data collection. Common elements between countries that needed further investigation were identified in this way.
Annual report writing workshops were held, bringing together researchers from all the four countries in order to share and shape individual country annual reports. This was particularly useful in understanding findings from other country context and learning how other countries were dealing with given problems. In addition, these meeting presented an opportunity to compare and harmonise feedback to Gavi. A cross-country report, synthesising the findings emerging from all the countries into cross-country themes was also worked on at the writing workshop. Since IHME and PATH had the advantage of knowing in detail the findings from each country, they were responsible for handling this component of the annual reporting, with input from country teams. Sharing of relevant information and lessons learnt between countries through conference calls and email and sharing of information relevant to the different countries on Basecamp cloud platform were other means of ensuring continued collaboration and information sharing.
Making better use of theories of change, a missed opportunity
In the final year of the evaluation, it became apparent that there was a need to have developed an overall evaluation framework detailing a TOC for the entire EPI programme rather than just for the various Gavi funding streams. As FCE findings, particularly cross-country findings, became clearer year after year it was apparent what the main drivers for successful EPI implementation were. It was thought by both Gavi and FCE implementers that these should have been the basis for the overall TOC and utilised to guide data collection and reporting year by year. This presented a lost opportunity for the FCE to make important comparisons in these elements from year to year within each country and across countries. This points to a rather common trait of process evaluation efforts in that there is general lack of clear, consistent definitions for key process evaluation components and lack of a systematic process for planning and developing complex process evaluation efforts in available literature (Linnan and Steckler, 2002; Saunders et al., 2005), although Linnan and Steckler (2002) and Saunders et al. (2005) do attempt to define this.
It is, however, quite difficult to have a one-size-fits-all solution given the huge variety and complexity of programmes being evaluated. Much learning and adjustment thus occurs in the course of the evaluation. Although, the overarching TOC was developed in the final year and an attempt was made to analyse the data in this way, it was a lost opportunity for the FCE to have done this in a more comprehensive manner. However, it must be remembered that at the beginning of such an evaluation it may be difficult to have a well-described TOC due to lack of existing information and this may only become clearer as data are gathered during the evaluation itself, as was the case here. This difficulty of gathering theory validating evidence is one of the limitations of developing a TOC, particularly in early stages (Care International, 2012).
Process evaluation can, however, also be a means of understanding and improving the TOC once it has been developed and utilised (Linnan and Steckler, 2002; McIntyre et al., 2018). In this case, this was another missed opportunity because other than developing an overall TOC as described, the findings were not used to question or modify the initial assumptions upon which individual funding stream TOCs were based. Thus, the TOCs did not evolve over time through the use of FCE findings. McIntyre et al. (2018) conducted a systematic review of 123 process evaluations and found that none had built or created theory, illustrating that this was by no means a unique challenge to the FCE. However, given that the FCE was planned to continue at the time of writing this article, it is still possible to use the overall findings to adjust these theoretical constructs and outline which elements were more influential in affecting successful programme implementation in order to inform future theory-informed interventions (Linnan and Steckler, 2002).
Lessons learnt
This section summarises key learning points from each of the foregoing sections.
Evaluation relevance and usefulness to programme implementers
During real-time evaluation, it is important for evaluators to be relevant to a programme’s ongoing data and information needs.
Evaluators must ensure that stakeholders understand the role of the evaluation, its scope and limitations, so as to manage expectations and ensure boundaries are set.
Information should be disseminated in various ways to meet different stakeholder requirements and in a manner that makes efficient use of their limited time.
Prioritising what data are needed and how it should be collected is important to make optimal use of limited resources for both implementers and evaluators.
Evaluation integration in ongoing programme activities is important to minimise the need for additional dedicated time from stakeholders to provide information to the evaluation.
Specific activities that require dedicated stakeholder time, such as KIIs, should be minimised but used effectively and conducted efficiently.
Evaluator roles and balance
Bias should be avoided in the evaluation and balance must be reached between reporting negative findings and positive findings.
Sharing of sensitive information in evaluation reports must balance stakeholder evaluation needs and the strength of evidence for such information.
Real-time evaluation requires the evaluator to build good relationships and rapport with people in the programme being assessed so that the evaluator is seen as a valuable partner rather than just an outsider grading performance.
Utilising a mixed-method approach incorporating both qualitative and quantitative methods in real-time evaluation yields better triangulation and results than employing just one approach.
Meeting needs of evaluation funders and collaborating with partners
An overall evaluation framework should be developed with a TOC for the entire programme, in combination with TOCs for individual programme components, for the evaluation right from inception to guide data collection and aid year to year comparisons.
Process evaluation should be used as a means of understanding and improving the TOCs on which the adopted approach is based.
Consistent communication and ongoing collaborative effort with the evaluation funders and evaluation partners is necessary to keep on track with their information needs.
Conclusion
Real-time evaluation can be a complex evaluation methodology that requires sensitivity to the context of the evaluation, catering for various information needs of stakeholders, and establishment of mutually beneficial relationships between programme implementers and evaluators. When used appropriately, it can be an effective means of informing programme decisions and aiding programme improvement for both donors and local implementers. This article has outlined several lessons learned by the Zambia FCE team that would be of value for future work of this nature. The Zambian experience of real-time evaluation shows that this can be an effective and valuable approach to programme evaluation that can assist in informing programmes on a timely basis and thus aid in improving programme implementation and achievements.
