Abstract
Project selection is a significant decision-making process in most companies. Most previous researches focused only on the investment profit and used random variables to determine project parameters. However, in some cases, the distributions of parameters cannot be obtained from similar projects due to the rapid changing environment. So experts’ estimations will be adopted. In order to handle inaccurate estimation, an uncertainty theory is applied to solve project selection decision-making in this situation. In addition, besides considering financial aspects, the non-financial aspects including compatibility, are taken into account. A new project selection model is developed and the deterministic form of the model is given. For the sake of illustration, an example has been presented. This paper aims at proposing a new project appraisal method comprehensively considering financial and non-financial aspects.
Introduction
Selection of the most appropriate projects from several candidate projects is an important investment decision to many companies. In the past, project selection method used to focus only on investment profit [1]. According to the classical theory of investment, project selection used to examine whether the net present value (NPV) or expected NPV is greater than zero. Obviously, this is the “golden rule” for investors to select the optimal projects from alternatives.
NPV only shows comprehensive result of the discounted streams of net cash flows without paying attention to the individual net cash flow. However, this consideration has some flaws. For example, the NPV value of a project is positive, but for some continuous years, the net cash flows are negative. It is clear if the company can have enough capital to support itself in those bad years, the company can still make profits from this project. Unfortunately, the company may not be able to have enough money to pull through the bad years so that it cannot finally benefit from the project. Obviously, this situation shows poor sustainability of the project. And in some extreme situations, the company may go bankruptcy due to the huge negative net cash flows. Therefore, we propose that both the aggregate result of NPV and the number of negative net cash flow years should be considered. If the number of negative net profit accounts for a small number, or almost zero, the project sustainability is considered better; otherwise not.
NPV and sustainability evaluate projects only from financial aspects without considering the important non-financial aspects, e.g. strategic compatibility. Non-financial aspects are argued to be taken into account when selecting projects. Sherer [17] argued that strategic viewpoints would affect the assessment of the type of project. Gerry et al. [7] pointed out that the strategic matching degree influenced decision making. They all stressed the importance of strategic matching degree, so the strategic matching degree can make a great difference to the decision of a project selection. For example, if Louis Vuitton whose target market is high-end consumers, decides to invest a project which produces ordinary students’ schoolbags, it still may be a disaster for the company despite the profit it might make. Therefore, we take the strategic matching degree into account when selecting projects.
Furthermore, whether the project has some effects to other businesses in the company is another point that needs consideration. Danese and Kalchschmidt [3] have provided evidence that synergistic effects among forecasting practices influence companies’ performances. For example, a large enterprise group with businesses in disparate fields such as car and drinking water invests a new project which manufactures engines. Obviously, this project will make synergistic effect to the existing car business. If the company chooses the project which produces shoes, this new project makes no difference to the existing businesses in this company. Therefore, we take the synergistic degree of the project to other businesses in the corporation into account when selecting projects.
Since project selection is done in complex economic environment, investors usually cannot predict parameters exactly. Therefore, indeterminate project parameters were considered. In the past, these indeterminate project parameters used to be considered as random variables [6, 12]. However, economic environment is changing fast, so sometimes distributions of parameters of candidate projects cannot be given by the historical data of similar projects but have to be assessed by experts, such as R&D projects. It is difficult for us to predict the exact values of project parameters in real life. Since imprecise estimations are not random in nature, treating estimations as random variables can cause counter intuitive results [9, 18]. To better handle imprecise estimations, Liu [14] proposed an uncertain measure and developed an uncertainty theory and refined it in 2010 [13]. With uncertainty theory, no paradoxes appear in decision making. For this reason, uncertainty theory has been widely used in decision making problems in uncertain environment. An important application is by Huang [10] who founded the uncertainty portfolio selection theory by systematically applying uncertainty theory to portfolio selection. Other applications can also be found in shortest path [5], inventory [16] and facility location [8], etc. In project selection with parameter values estimated by experts, Zhang et al. [19] studied how to select domestic projects, Zhang et al. [18] studied how to select international projects, and Huang and Zhao [9] studied project selection and adjustment, based on uncertainty theory. However, in their selection method, only profit aspect from the project investment is considered. In this paper, we will go on studying project selection problem in such environment. Different from existing studies, uncertainty theory will be used to solve the project selection problem considering non-financial aspects. Furthermore, NPV will be improved considering sustainability of projects.
The rest of the paper is organized as follows. Firstly, the compatibility and sustainability index as well as an uncertain project selection model will be proposed in Section 2. In addition, the equivalent form of the model is represented in Section 3. To illustrate the application of the model, an example is provided in Section 4. Finally, conclusion is provided in Section 5. What’s more, in order to understand the paper well, fundamentals of uncertainty theory will be briefly reviewed in the Appendix.
Uncertain project selection model
To solve the uncertain project selection problem, a corporation should select projects considering financial and non-financial aspects. Suppose all candidate projects begin to produce net cash flow at the end of each year. In this paper, we use the following notations for the convenience of expression:
IO h : The initial outlay of project h;
N
h
: The number of negative net cash flow years of project h. Define Nh,t = 1, when NCFh,t satisfies
T h : The number of the years that the project h will last;
r: The discount rate;
w1: The weight of
w2: The weight of
x h : Decision variables which are defined by
NPV
Due to the time value of money, we should use the present value to describe the current cash value. Considering the meaning of IO
h

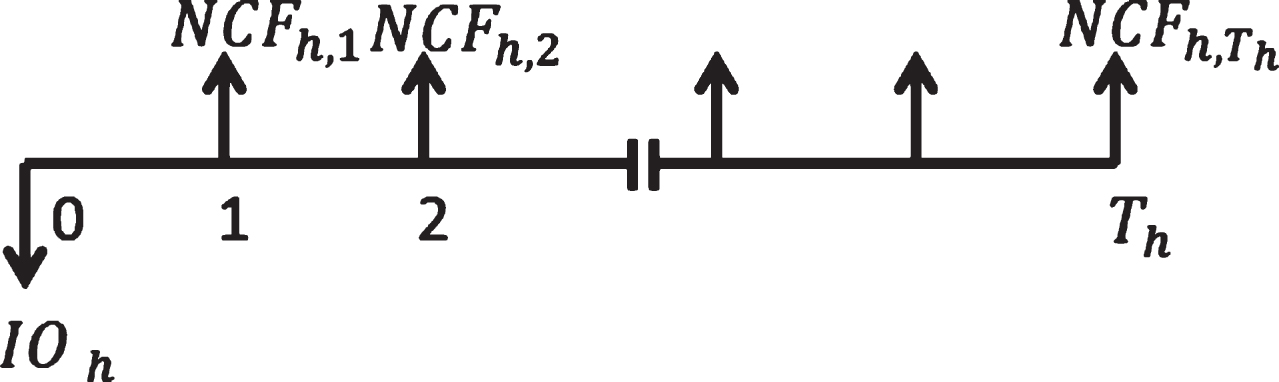

, it can be described as a definite value. The net cash flows of the project h is demonstrated in Fig. 1. Therefore, the NPV
h
in this case is

Cash flows of the project h.
Therefore, the total investment return in NPV form is
Besides thinking about the NPV, we should also consider the sustainability of the projects. The sustainability index of project h is defined as
The lower the
We integrate strategic matching degree and synergistic degree into one compatibility index, which is defined by
Since
Since every corporation has a capital limitation, let b be the available maximum capital. Then the capital limitation can be expressed as follows:
Thus, if the company wants to obtain the maximum expected NPV, and requires that the selected projects should satisfy the sustainability index and compatibility index requirements, with the capital limitation, the company should select the project portfolio according to the following model:
Suppose
According to Definition 1 self-duality property of the uncertain variable, the formula (4) can be changed into the following form.
Therefore, we can change constraint (8) into the standard form:

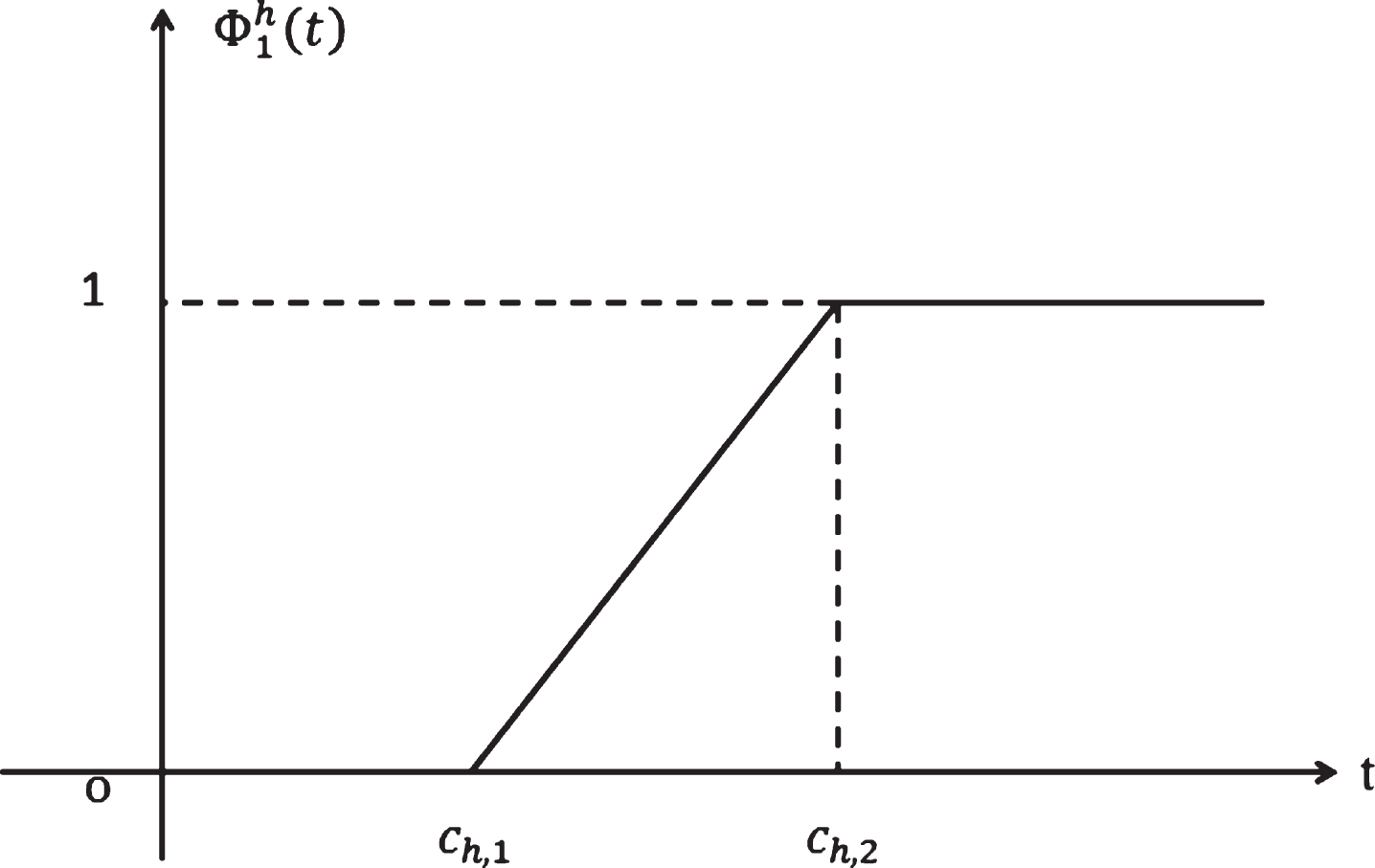

Uncertainty distribution of a linear uncertain variable (
Then the uncertain project selection model can be converted into the following form:
Furthermore, if
The net cash flows of 10 candidate projects (Unit: million dollars)
According to experts’ estimations, the distributions of
The parameter information about the distribution of
We express it by
Then Equation (10) can be transformed into x h (w1ch,1 + w2dh,1) α + (1 - α) (w1ch,2 + w2dh,2) x h ≥ p h .
Let x h (w1ch,1 + w2dh,1) α + (1 - α) (w1ch,2 + w2dh,2) x h = CI h . Then model (11) can be changed into the following equivalent:
To illustrate the application of the proposed model, an example is presented here. Table 1 shows the net cash flows of 10 candidate projects.
Suppose that the investor only has 40 million dollars, i.e., b = 40, and sets p h = 4, C = 0.2, w1 = 0.44 and w2 = 0.56. If α is determined at 0.95 and β at 0.65, according to model (12), the investor should select projects 4, 7 and 9. The objective value is $23.70 million.
Conclusions
This paper has solved a project selection problem in which project parameters are given by experts’ evaluations for the lack of historical data from similar projects. Uncertain variables have been used to describe these parameters. Based on uncertainty theory, a project selection model has been presented considering not only NPV and capital limitation, but also compatibility index and sustainability index. Aiming at solving the problem, a deterministic equivalent of the model has been put forward. At last, an example has been provided to illustrate the application of the model.
