Abstract
The construction industry has long been seen as a high-risk industry, and the risk evaluation method is the core of safety risk management. Complex construction environments can lead to risk evolution over time, leading to uncertainty in risk assessment. Therefore, it is necessary to establish a risk evaluation method for multi-period group decision, which can also deal with uncertain information reliably. This study defines the risk evaluation indicators for construction safety and adopts the cloud model to deal with the uncertain information of experts’ evaluations. A cloud-based aggregation algorithm is also employed for group decision. Then, a cloud-based Minkowski distance function is proposed to enhance the ability of TOPSIS to deal with the uncertain information. Finally, an optimization algorithm is used to calculate the multi-period comprehensive evaluation value to define the risk priority. A real case is used for demonstration and the results show that the proposed method can effectively deal with the risk evaluation problem of multi-project, multi-period and group decision with uncertain information.
Introduction
The construction industry has long been seen as a high-risk industry in the world [50]. Many scholars have devoted into the research of construction safety risk management, including the construction risk evaluation. Some effective mathematical models have been introduced into the field of construction safety risk evaluation and obtained well achievements.
AHP is an effective tool to deal with the complexity in construction risk evaluation. It can provide a systematic approach to structure risk evaluation problems [5, 13]. Bayesian network-based fault tree analysis (FTA) can prioritize construction safety incidents and evaluate accident rates [15, 49]. The Monte Carlo Method (MCM), the Failure Model and Effect Analysis (FMEA) are also commonly used to assess construction safety risk effectively [22, 51]. In addition, fuzzy set theory can deal with uncertainty in the evaluation process [10, 33].
However, AHP is based on expert experience, which leads to personal bias and uncertainty in the evaluation process [36]. Moreover, construction safety risks evolve dynamically over time [4, 24], but the above methods can only statically assess risks within a certain period, and cannot reflect comprehensive risks in multiple periods. In addition, the risk level is usually represented by numerical value in the current methods. Thus, fuzzy set theory can only solve the uncertainty of the data itself, and cannot deal with the uncertainty of the data source. In fact, human evaluation is vague and not suitable for expression in accurate numbers, so it is better to use linguistic variables to describe evaluation [38].
Therefore, the main task of construction risk evaluation is still to establish a risk evaluation mathematical model that is robust and reliable and can describe uncertain information. This study adopts the cloud model to deal with the uncertainty of experts’ evaluations, which can effectively describe the ambiguity and randomness of the uncertain information. The ability of describing the uncertain information can improve the reliability of construction risk evaluation. Then, an aggregation algorithm based on cloud model is established to integrate group evaluations and build the cloud risk evaluation matrix. In the single-period risk evaluation, the cloud-based Minkowski distance function is proposed to enhance the ability of TOPSIS for uncertain information. Thus, the cloud-based distance can be used to measure the closeness of the ideal solution. Finally, an optimization algorithm is used to calculate comprehensive evaluation value of the multi-period to define the risk priority.
In summary, this study uses cloud model to describe linguistic variable evaluation and process uncertainty from data source. C-TOPSIS (Cloud-based TOPSIS) based on Minkowski distance function is established to improve the robustness of TOPSIS. An optimization algorithm is used to aggregate multi-period evaluation values to solve the problem that construction safety risks evolve with time. A real case of construction safety risk evaluation is used to verify the feasibility and practicability of the proposed method, and also to demonstrate the solution of multi-period group risk evaluation with uncertain information.
The paper is organized as follows: Section 2 reviews the methods used in this paper. Section 3 describes the proposed method in detail; Section 4 shows the illustrative example and discussion of the proposed method. The paper concludes in Section 5.
Related works
Construction risk evaluation
Risk evaluation is the core of the construction risk management. Generally, construction risk indicators are firstly defined to identify the construction risk impact factors, and the construction risk can be measured qualitatively or quantitatively. An effective evaluation algorithm is then built to calculate the construction risk situation to further control it. In addition, an appropriate technique to deal with uncertain information can enhance the reliability and flexibility of the risk evaluation results. Many studies have been conducted in different steps of construction risk evaluation and have achieved well results.
In the identification of construction risk indicators, Hinze et al. proposed [12] leading indicators, which are different from the traditional lagging indicators of construction risk evaluation, and verified that the leading indicators can be used to distinguish the differences in project safety performance. Pinto established [34] the occupational safety risk evaluation model for the construction industry and defined the construction risk evaluation indicators into four aspects: safety climate, severity factors, possibility factors, and safety barriers. Wu et al. defined [43] construction risk evaluation as 26 indicators and classified them into five aspects: safety climate, safety culture, safety attitude, safety behavior, and safety performance. The structural equation model (SEM) was used to verify the effectiveness. Lingard et al. investigated [18] the relationships among the safety performance indicators, including the lagging indicators and the leading indicators, and indicated that the leading indicators can be more effective. Gunduz and Ahsan ranked [9] the risk indicators, considering both their importance and frequencies, and defined the priority.
In the related methods of construction risk evaluation, commonly used methods such as AHP, FTA, MCM, etc. Zhang et al. proposed [48] a probability decision method, based on triangular fuzzy numbers, for subway construction risk analysis in complex engineering environment. Taylan et al. used [37] fuzzy analytic hierarchy process (FAHP) to measure the weights of fuzzy linguistic variables of the project risks, and adopted the fuzzy TOPSIS method to solve the group decision problem in the fuzzy environment. Zhang et al. proposed [47] a hybrid approach, which merges Fuzzy Matter Element (FME), Monte Carlo (MC) simulation technique, and Dempster-Shafer (DS) evidence theory, to calculate the risk degree at the early construction stage. Gao et al. established [6] a comprehensive risk evaluation model of tunnel collapse based on entropy weight and grey relational degree. Huang et al. integrated [13] AHP and grey relational analysis to build an AHP-Grey Model for construction safety evaluation. Koulinas et al. used [5] the Fuzzy Extended Analysis Hierarchy Process (FEAHP) to prioritize construction site risks for presenting a quantifiable analyze method of risk evaluation.
In the methods of describing uncertain information, Qiu et al. used [35] the fuzzy Delphi analytic hierarchy process (FDAHP) and the grey relational analysis (GRA) method to build a combination method to assess the risk of water inrush. Peng and Liu used [31] grey system theory to calculate objective weights to compensate for the uncertainty of subjective weighting. Peng et al. used [27] the cloud model to build a method for multi-criteria group decision making with uncertain pure linguistic information. Peng and Garg proposed [30] an interval valued fuzzy soft decision algorithm based on Weighted Distance Based Approximation (WDBA), COmbinative Distance-based ASsessment (CODAS) and similarity measure. It can obtain the optimal alternative without counterintuitive phenomena. Liu et al. used [19] interval grey fuzzy uncertain linguistic set to establish a ranking model for construction project risk factors. Gunduz et al. applied [10] the fuzzy set theory and the Structural Equation Model (SEM) to develop a construction safety performance indicator evaluation software. Liu et al. integrated [20] the cloud model, the Failure Model and Effect Analysis (FMEA) and the Technique for Order of Preference by Similarity to Ideal Solution (TOPSIS) to propose a risk ranking method. In addition, Pythagorean fuzzy set is often used to deal with the uncertainty of multi-attribute decision making [32]. As discussed in the above mentioned literatures, multi-attribute decision-making (MADM) models are often used in the risk evaluation, such as TOPSIS, AHP and grey relational analysis, to evaluate the risk degree of the construction site. Fuzzy numbers, gray numbers and cloud models are mostly used to deal with the uncertain information, and the cloud model can simultaneously deal with the ambiguity and randomness of uncertain information. Cloud model has also demonstrated its practicability in related applications.
Cloud model
The cloud model establishes a transformation model between the qualitative concept (based on semantic description) and the quantitative representation (through a specific algorithm), which can simultaneously deal with the ambiguity and randomness of uncertain information. Let U be an universe which is represented by exact number, corresponding to the qualitative concept
The cloud model is composed of three parameters, as shown in Fig. 1, including the expectation value (Ex), the entropy (En), and the super entropy (He). is the expectation of the distribution of cloud droplets in the universe, i.e., the most representative qualitative concept value. En is a measure of the randomness and ambiguity of qualitative concepts, reflecting the degree of dispersion of cloud droplets. He is the entropy of En, which is a measure of the uncertainty of entropy, reflecting the thickness of the cloud. The overall shape of the cloud reflects the characteristics of the uncertain information. When a large number of cloud droplets is producing, the regularity of the concept will be clearer.

The parameters of cloud model.
Since the cloud model can well deal with the uncertain information, it has been widely used in many fields and has achieved good results. Wang et al. proposed [42] a decision-making method based on cloud model, which can solve the multi-standard group decision problem with known indicators’ weights, unknown decision makers’ weights and the interval linguistic variables. Wang et al. used [40] the cognitive cloud model with the probability statistics and the fuzzy set theory to build a water quality evaluation method. Wu et al. used [44] the cloud model to construct a Cloud Choquet Integral (CCI) operator to evaluate the Waste-to-Energy (WtE) performance to select the best site. Peng et al. used [28] a cloud model to process probabilistic language terminology and established a hotel decision support model to assist tourists in choosing the most suitable hotel. Liu et al. proposed [21] a cloud model-based safety evaluation method for prefabricated building construction to control the accidents in the production process of prefabricated buildings.
TOPSIS proposed by Hwang and Yoon [14] is a commonly used method in multi-attribute decision making. The ranking of the scheme is calculated by measuring the distance between the alternatives and the ideal solution (and the negative ideal solution) to calculate the closeness of the ideal solution. The TOPSIS algorithm is as follows [7, 39]:
Let x
ij
be the evaluation value of the i-th alternative on the j-th indicator, then the decision matrix is built as
In order to make the evaluation values comparable between the indicators, the decision matrix needs to be standardized. The unit vector method is the commonly used standardized method in TOPSIS. Let r
ij
be the standardized evaluation value of x
ij
, then
The ideal solution defined as the maximum value of the larger-the-better indicator set (J1) and the minimum value of the smaller-the-better indicator set (J2). The negative ideal solution is opposite. Therefore, the positive ideal solution (A+) and the negative ideal solution (A-) can be defined as
Framework of the proposed method.
Euclidean distance function is used to calculate the distance (
The closeness of the ideal solution (
The larger the value, the closer it is to the ideal solution. The corresponding alternative is ranked higher.
TOPSIS’s algorithm is clear in logic and simple in calculation. Hence, it is widely used in many fields, including construction risk evaluation issues. Barros and Wanke used [1] the TOPSIS method to evaluate the African airlines efficiency. Mir et al. applied [23] a modified TOPSIS methodology for Municipal Solid Waste (MSW) problems. Peng and Dai used [29] TOPSIS to deal with the real MADM problems. It can efficaciously solve decision-making problems with the inconsistent information which exist commonly in real world. Yurdakul and İç developed [46] a multi-level performance measurement model for manufacturing companies using a modified version of the fuzzy TOPSIS approach. Oz et al. extended TOPSIS model with Pythagorean fuzzy sets to assess occupational health and safety (OHS) risk in natural gas pipeline project [26]. Gul and Ak combined Pythagorean fuzzy analytic hierarchy process (PFAHP) with fuzzy technique to rank hazards by the similarity and ideal solution (FTOPSIS) method [8]. Colak et al. used type-2 fuzzy AHP and hesitant fuzzy TOPSIS methods to prioritize risks to help manufacturing industry transition [3].
Framework

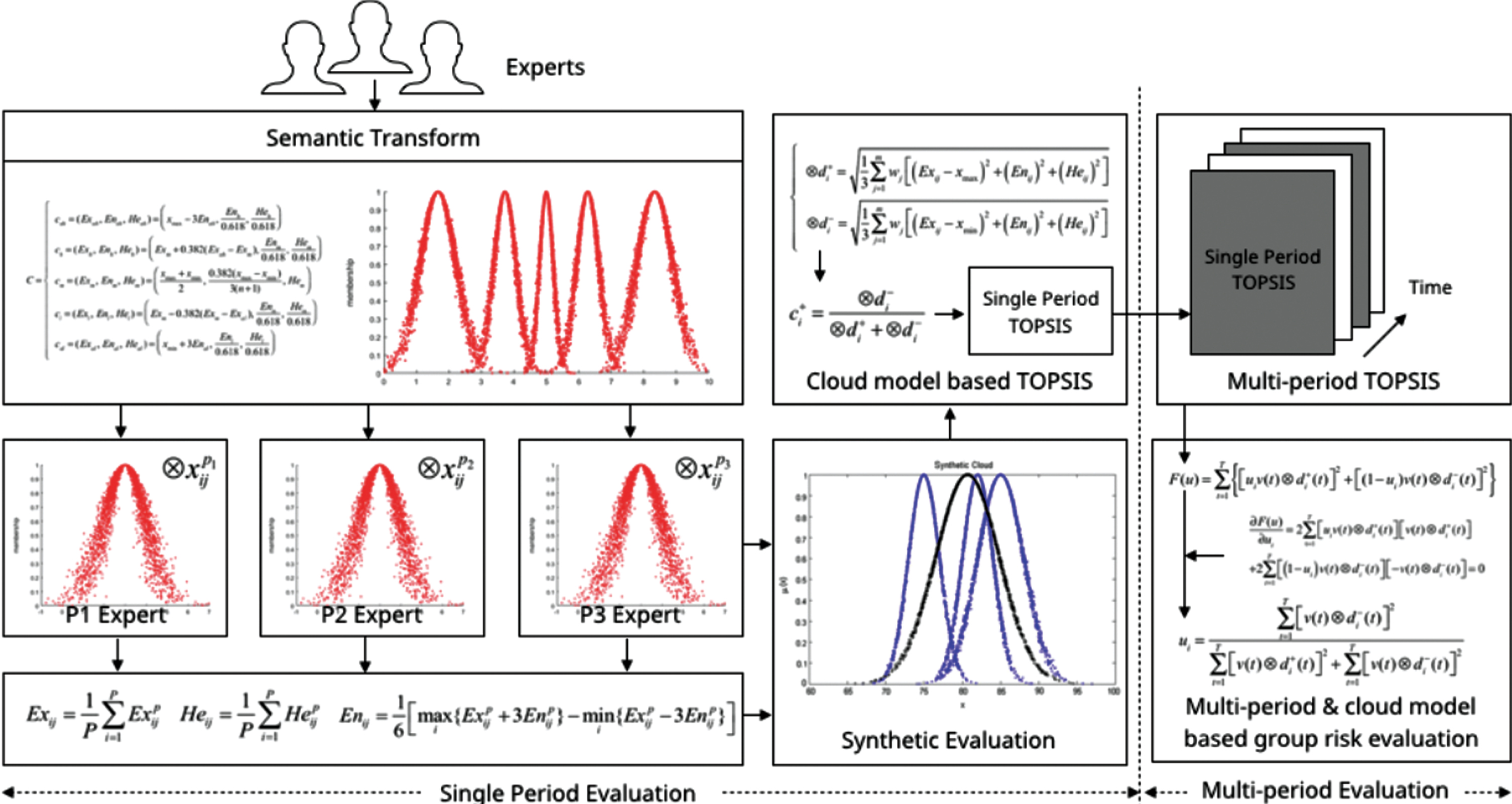

In order to deal with the uncertain information caused by the complex environment of the construction site and to solve the problem of multi-period group decision making, this paper combines the cloud model, TOPSIS and the optimization algorithm to propose a multi-period construction risk evaluation method under the uncertain information. The framework of the method is shown as Fig. 2.
First, in order to describe the uncertainty of the expert’s evaluation, this study uses the risk semantic evaluation and the golden section method based on cloud model to transform qualitative semantics to quantitative values. Then, to aggregate the experts’ evaluations, the cloud model is also adopted to build the cloud risk aggregation evaluation matrix. Subsequently, this paper proposes a cloud-distance function, which is integrated with the cloud model and the Minkowski distance function, to extend TOPSIS to C-TOPSIS (cloud-based TOPSIS) to deal with risk ranking in an uncertain information environment.
Finally, a multi-period aggregation algorithm is proposed, which combines the multi-period evaluation results to give a reliable evaluation and ranking.
Construction risk evaluation indicators and cloud membership functions
Chou summarized [2] a large number of literatures and collected a complete hierarchy of construction risk evaluation indicators, which were divided into 6 categories and 23 indicators. In addition, an investigation based on the analytic hierarchy process was conducted to define the weights of the indicators. Chou provided a reasonable indicators system of construction risk evaluation. Therefore, this paper develops the multi-period risk evaluation method based on these indicators, as shown in Table 1.
Construction risk evaluation indices and weights
Construction risk evaluation indices and weights
In the definition of cloud membership function, this paper defines the effective universe is U = (xmin, xmax). Risk is classified into five levels, i.e., absolutely low (al), low (l), moderate (m), high (h), and absolute high (ah). Then, the golden section method [16] is used to define the five cloud membership functions of risk levels as
In Equation (6), the value of He m should be set in advance according to the indicator characteristics and the evaluation requirements.
In the risk evaluation algorithm of multi-period group under the uncertain information environment, there are three problems needed to be solved: the synthetic cloud evaluation matrix of experts’ evaluations; the distance function based on cloud model to calculate the closeness degree in the synthetic cloud evaluation matrix; the multi-period aggregate evaluation algorithm to provide a reliable comprehensive evaluation. The algorithms of the above three problems are described as follows.
The algorithm of the synthetic evaluation cloud matrix
Let ⊗X
p
be the cloud risk evaluation matrix given by the p-th expert.

Cloud model synthesis.

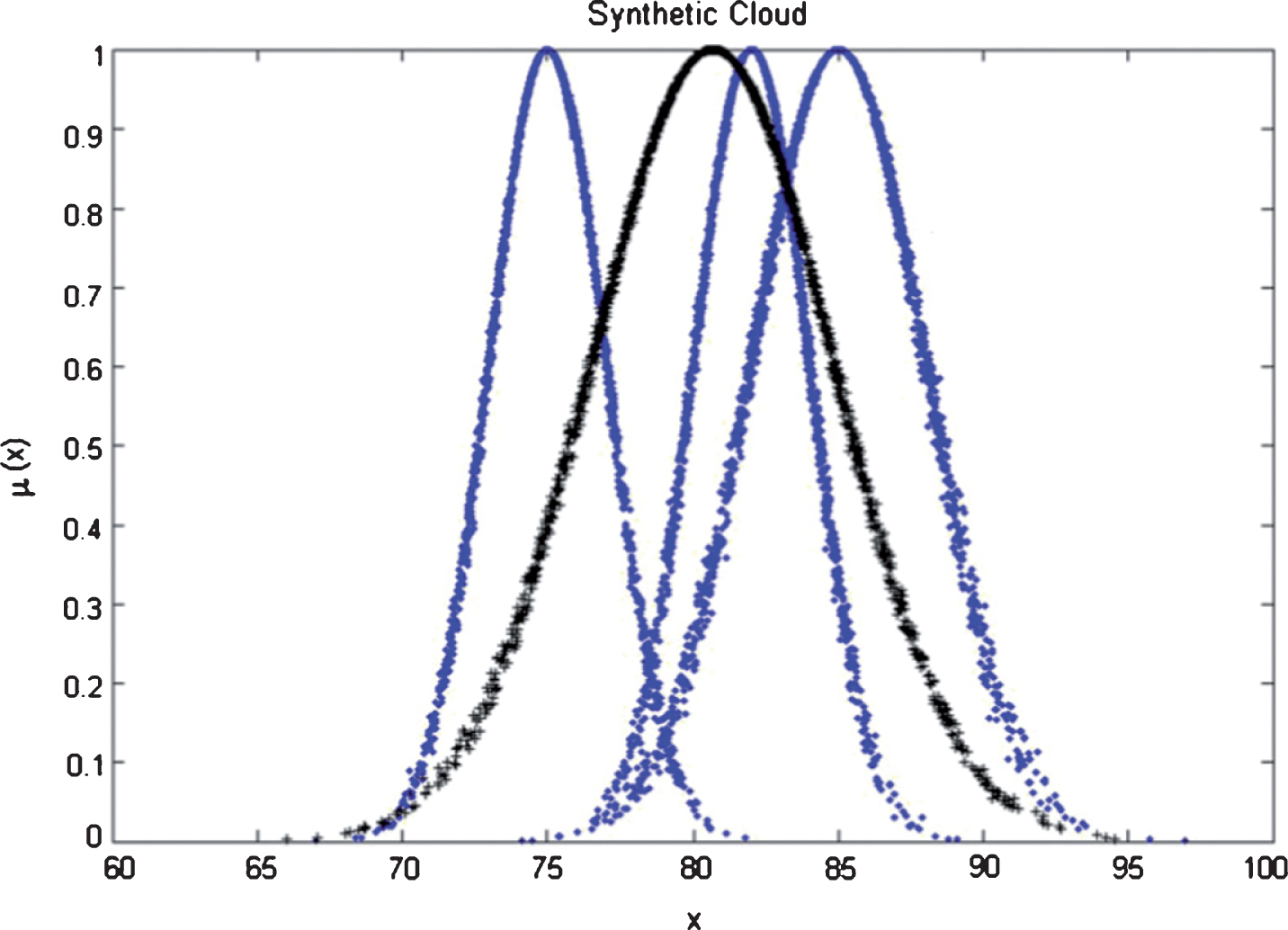

The concept of cloud model synthesis is shown in Fig. 3. Equation (8) can be used to integrate experts’ cloud evaluations into a synthetic cloud.
C-TOPSIS is proposed in this paper to extend TOPSIS in the cloud environment and several problems need to be solved in C-TOPSIS applications. The first problem is the definitions of the ideal solution and the negative ideal solutions. The definitions of traditional TOPSIS are as shown in Equation (3). However, in C-TOPSIS, the evaluation value is extended from the exact number to the cloud model, which is composed of three parameters. Under this condition, the definitions of the ideal solution and the negative ideal solution also need to be modified. The ideal solution and the negative ideal solution of cloud model can be defined as follows. Let the effective universe U = (xmin, xmax), then
The second problem is the calculation of distance between cloud models. This paper extends the distance functions proposed by Lin et al. [17] and Liu et al. [20]to combine the cloud model and the Minkowski distance function to redefine
Semantic risk evaluations of the foundation engineering period
Note. There are five construction sites (S1 to S5) and three experts (E1 to E3).
Expert evaluation cloud matrix of the foundation engineering period
Synthetic evaluation cloud matrix of the foundation engineering period
Most risk evaluations are often conducted based on single period records. However, the condition of construction risk changes with progress and the aggregation evaluation of multi-period would provide more reliable results. Therefore, this paper adopts the multi-period aggregation algorithm [17] to complete the multi-period cloud-based risk evaluation method. Let v (t) denote the weight of the t-th period (t = 1, 2, . . . , T) and then the stage weight vector is
The stable solution of u
i
can be obtained when
Then, u
i
can be defined as
Case background
A real case in Chengdu, China is used for demonstration. Five construction projects are chosen and three experts are invited to conduct risk evaluation in three periods (the foundation engineering period, the main structural engineering period, and the roofing engineering & installation period). They evaluate the construction risk situation based on the indicators listed in Table 1. Five semantic risk levels are used, i.e., absolutely low (AL), low (L), moderate (M), high (H), absolute high (AH). According to experts’ opinions, the period weights are set as equal.
Results
Take the first period (foundation engineering) as example, the semantic risk evaluation matrix is obtained in Table 2.
Then the semantic evaluation matrix is converted into the cloud-based evaluation matrix. Let U = (0, 10) and He
m
= 0.020, then the following semantic evaluation cloud is obtained
Therefore, the semantic evaluation cloud can convert the qualitative semantic evaluation into the quantitative evaluation cloud, and obtain expert evaluation cloud matrix, as shown in Table 3.
Then, experts’ evaluations can be integrated according to the group cloud synthetic algorithm described in 3.3.2, and the synthetic evaluation cloud matrix for foundation engineering period is obtained, as shown in Table 4
The indicators for this study are the smaller-the-better type, so the positive and negative ideal solutions, according to Equation (9), are A+ = (0, 0, 0) and A- = (10, 0, 0), respectively. Therefore, the distance from the evaluation cloud matrix to the ideal solution and the negative ideal solutions are calculated according to Equation (10). Then the C-TOPSIS ranking results of the five project in the foundation engineering period are shown in Table 5, and the risk ranking can be determined as 2 ≻ 1 ≻5 ≻ 3 ≻4.
C-TOPSIS calculations of the foundation engineering period
C-TOPSIS calculations of the foundation engineering period

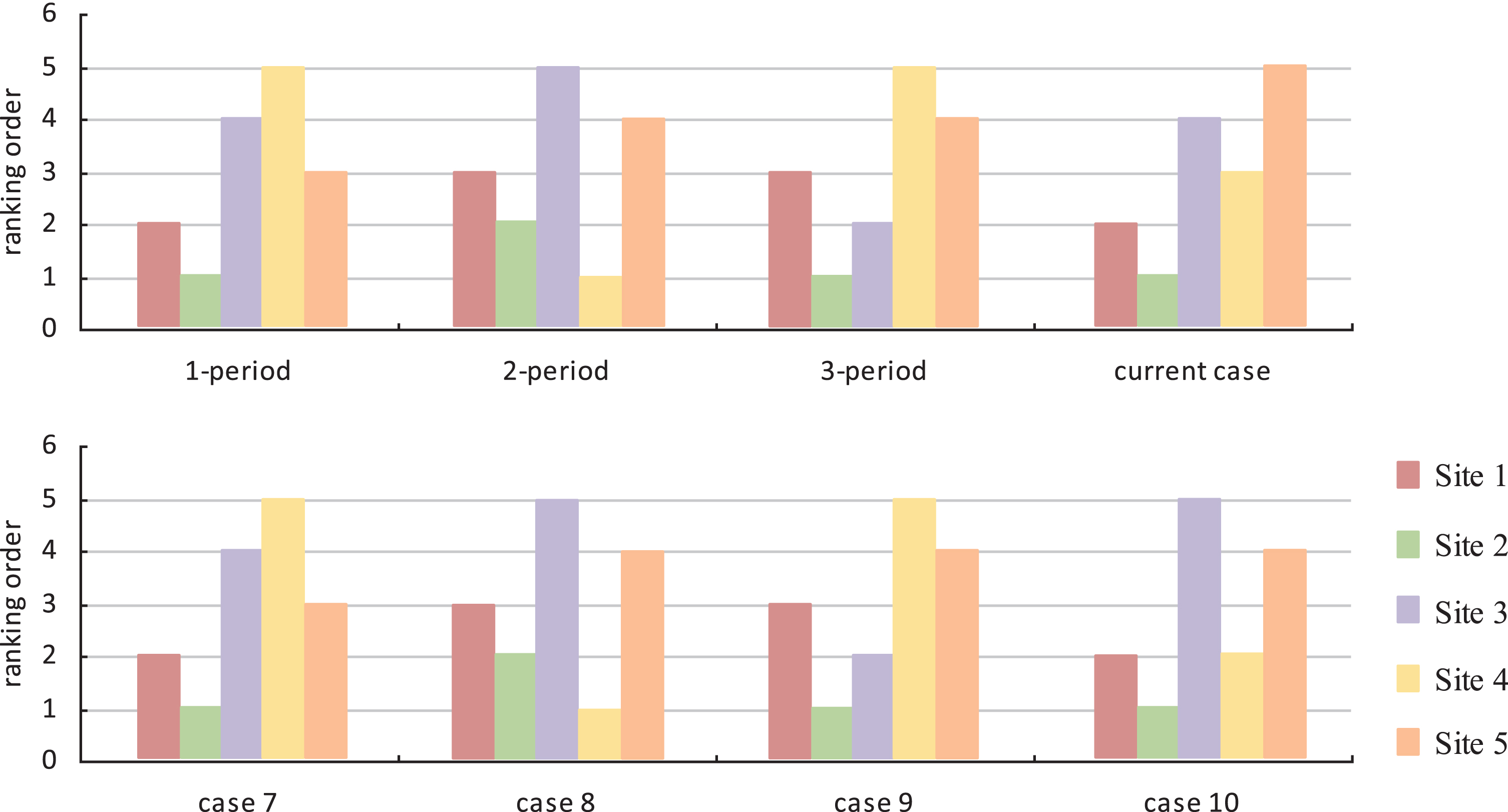

Robustness analysis results.

Effectiveness analysis results.
In the same way, the C-TOPSIS results of the main structural engineering period (2-Period) and the roofing engineering & installation period (3-Period) can be obtained, as shown in Table 6. The risk rankings of the main structural engineering period and the roofing engineering & install period are 4 ≻ 2 ≻5 ≻ 1 ≻3 and 2 ≻ 3 ≻1 ≻ 5 ≻4, respectively.
The multi-period comprehensive evaluation results
Risk evaluation is often conducted by single period. Although the cloud model can be used to solve the ambiguity and randomness caused by the uncertain information, C-TOPSIS is still used in single period. Therefore, the multi-period aggregation algorithm in Section 3.3.2 can be used to calculate the comprehensive evaluation.
The weight vector of periods is assumed equal. According to the Equation (13), the multi-period comprehensive evaluations are calculated as Table 8: The construction safety risk ranking of these five projects is 2 ≻ 1 ≻4 ≻ 3 ≻5.
In order to evaluate the safety risk of the construction project more intuitively, C-TOPSIS and aggregation algorithm are calculated for the semantic evaluation indicator cloud in 4.1, and the ideal solution closeness of the semantic evaluation indicators is obtained. Therefore, an evaluation standard based on the representation of the ideal solution closeness is established, as shown in Table 7.
The evaluation standard based on the ideal solution closeness
The evaluation standard based on the ideal solution closeness

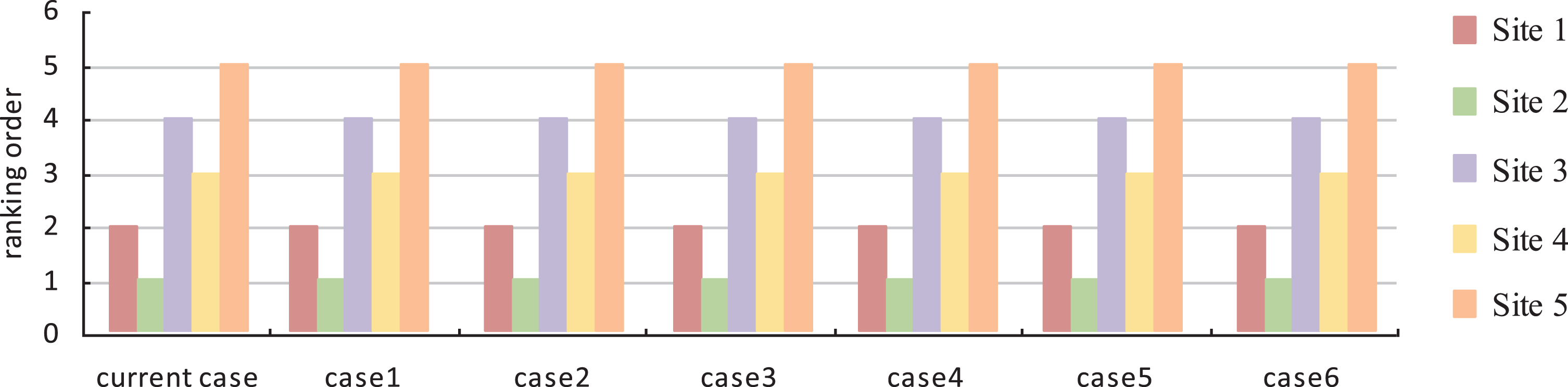

The application case weights of robustness analysis
Tables 6 and 7 can be further compared to obtain the following conclusions:
Most of the projects in the evaluation sample are between medium risk and high risk, with relatively high construction safety risks. It can be inferred that the construction safety risk of the projects in Chengdu is poor. The relevant management departments should organize large-scale inspections to confirm the construction safety risks of the projects, and order the rectification of unqualified projects. The ideal solution of project 2 is 0.60, which is between medium risk and low risk. Compared to the other four projects, project 2 has a lower construction safety risk. The safety risk management method of project 2 construction site is analyzed to provide reference for other project rectification.
In order to verify the robustness and reliability of proposed method, the period weights are adjusted to verify the effect of weights on the results. First, we adjust the period weights within 5% and 10% to verify robustness. The weight distributions are shown in Table 8: the weights of case 1 3 vary within 5% and the weights of case 4 6 vary within 10%. The results shown in Fig. 4 indicate that within 10%, the changes of the period weights don’t affect the ranking order. The proposed method can deal with the uncertainty caused by period weights. Thus, the proposed method is proved to be robust within 10%.
The application case weights of effectiveness analysis
The application case weights of effectiveness analysis
We also conduct five common distributions of construction safety risk based on expert suggestions to analyze the situation of the weights more than 10%. The specific weight distributions are shown in Table 9. The current case represents the equal distribution of risks in three periods, case 7 9 represent the risks of one of the three periods are higher than the other two, and case 10 represents the risks of the three periods have difference but not too large. The comparison of results were shown in Fig. 5. The weights of case 1 indicate that the accident probability in 1-Period is large. The results of case 1 are the same as the results of 1-Period C-TOPSIS. Furthermore, case 2 and case 3 show the same trends. In addition, the current case and case 4 both have a relatively even weight, and the results of the above two also show similar trends. The above results show that when the period weights change more than 10%, the proposed method can effectively reflect the timing-based risk relationship. The proposed method is reliable.
In the field of construction safety risk evaluation, the uncertainty of objective environment in construction site determines the uncertainty of subjective cognition of experts’ evaluation. These two uncertainties greatly reduce the accuracy of construction safety risk evaluation. In addition, construction safety risks evolve over time leading to instability in the evaluation results. This research attempts to resolve the above questions, and the research results are as follows:
The cloud-based TOPSIS technology (C-TOPSIS) is established to conduct construction safety risk evaluation, and semantic evaluation is used instead of mathematical expression to increase evaluation elasticity, thus reducing the uncertainty caused by the objective environment. The aggregation algorithm of multi-expert evaluation is used to reduce the data fluctuation caused by the subjective difference of individual evaluation and reduce the uncertainty of subjective cognition. The multi-period aggregation algorithm is established to realize the dynamic evolution based on the construction life cycle and improve the robustness of the risk evaluation for construction safety. Establish the multi-dimensional (alternative-indicator-group-time) evaluation method for construction risk under uncertain information. On the basis of establishing a robust risk evaluation method of construction safety, a solution scheme is provided for regional construction safety risk management.
The current study has some limitations as follows: (1) The proposed method can carry out effective risk evaluation, but lacks risk prediction. In the future, a prediction algorithm can extend the practicability; (2) the weights of periods are equal in this study. Future research may consider to use expert judgment to allocate the elasticity of weights; (3) The indices in this study come from the literature review, but each construction site has its own particularity. Thus, the future research can integrate knowledge map and data mining technology to build a risk index library, and develop recommendation algorithms to customize evaluation indices.
